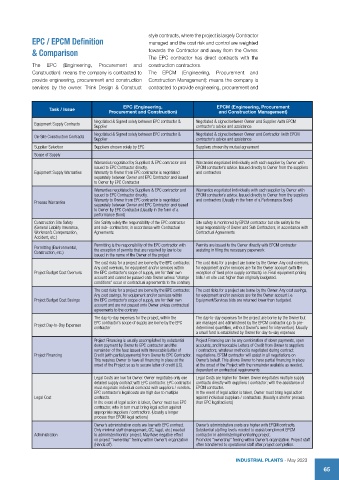

Page 67 - Industrial plants
P. 67

style contracts, where the project is largely Contractor
            EPC / EPCM Definition                    managed and the cost risk and control are weighted
            & Comparison                             towards the Contractor and away from the Owner.
                                                     The EPC contractor has direct contracts with the
            The   EPC  (Engineering,  Procurement  and  construction contractors.
            Construction): means the company is contracted to   The EPCM (Engineering, Procurement and
            provide engineering, procurement and construction   Construction Management): means the company is
            services by the owner. Think Design & Construct   contracted to provide engineering, procurement and



                                            EPC (Engineering,                EPCM (Engineering, Procurement
                  Task / Issue         Procurement and Construction)          and Construction Management)
             Equipment Supply Contracts  Negotiated & Signed solely between EPC contractor &   Negotiated & signed between Owner and Supplier /with EPCM
                                  Supplier                            contractor’s advice and assistance
                                  Negotiated & Signed solely between EPC contractor &   Negotiated & signed between Owner and Contractor /with EPCM
             On-Site Construction Contracts
                                  Supplier                            contractor’s advice and assistance
             Supplier Selection   Suppliers chosen solely by EPC      Suppliers chosen by mutual agreement
             Scope of Supply
                                  Warranties negotiated by Suppliers & EPC contractor and   Warranties negotiated individually with each supplier by Owner with
                                  issued to EPC Contractor directly.  EPCM contractor’s advice. Issued directly to Owner from the suppliers
             Equipment Supply Warranties  Warranty to Owner from EPC contractor is negotiated   and contractors
                                  separately between Owner and EPC Contractor and issued
                                  to Owner by EPC Contractor
                                  Warranties negotiated by Suppliers & EPC contractor and   Warranties negotiated individually with each supplier by Owner with
                                  issued to EPC Contractor directly.  EPCM contractor’s advice. Issued directly to Owner from the suppliers
                                  Warranty to Owner from EPC contractor is negotiated   and contractors (Usually in the form of a Performance Bond)
             Process Warranties
                                  separately between Owner and EPC Contractor and issued
                                  to Owner by EPC Contractor (Usually in the form of a
                                  performance Bond)
             Construction Site Safety  Site Safety solely the responsibility of the EPC contractor   Site safety is monitored by EPCM contractor but site safety is the
             (General Liability Insurance,   and sub- contractors; in accordance with Contractual   legal responsibility of Owner and Sub Contractors; in accordance with
             Workman’s Compensation,   Agreements                     Contractual Agreements
             Accident, etc.)
                                  Permitting is the responsibility of the EPC contractor with   Permits are issued to the Owner directly with EPCM contractor
             Permitting (Environmental,
             Construction, etc.)  the exception of permits that are required by law to be   assisting in filing the necessary paperwork
                                  issued in the name of the Owner of the project
                                  The cost risks for a project are borne by the EPC contractor.   The cost risks for a project are borne by the Owner. Any cost overruns,
                                  Any cost overruns, for equipment and/or services within   for equipment and/or services are for the Owner account (with the
             Project Budget Cost Overruns  the EPC contractor’s scope of supply, are for their own   exception of fixed price supply contracts) i.e. Final equipment pricing
                                  account and cannot be passed onto Owner unless “change   bids / on site cost higher than originally budgeted.
                                  conditions” occur or contractual agreements to the contrary
                                  The cost risks for a project are borne by the EPC contractor.   The cost risks for a project are borne by the Owner. Any cost savings,
                                  Any cost savings, for equipment and/or services within   for equipment and/or services are for the Owner account i.e.
             Project Budget Cost Savings  the EPC contractor’s scope of supply, are for their own   Equipment/Services bids are returned lower than budgeted.
                                  account and are not passed onto Owner unless contractual
                                  agreements to the contrary
                                  The day-to-day expenses for the project, within the   The day-to-day expenses for the project are borne by the Owner but
                                  EPC contractor’s scope of supply are borne by the EPC   are managed and administered by the EPCM contractor (up to pre-
             Project Day-to-Day Expenses
                                  contractor                          determined quantities, without Owner’s need for intervention). Usually
                                                                      a small fund is established by Owner for day-to-day expenses
                                  Project Financing is usually accomplished by substantial   Project Financing can be any combination of down payments, open
                                  down payment by Owner to EPC contractor and the   accounts, and Irrevocable Letters of Credit from Owner to suppliers
                                  remainder of the fees issued with Irrevocable Letter of   / contractors; whatever method is negotiated during contract
             Project Financing    Credit (with partial payments) from Owner to EPC Contractor.  negotiations. EPCM contractor will assist in all negotiations on
                                  This requires Owner to have all financing in place at the   Owner’s behalf. This allows Owner to have partial financing in place
                                  onset of the Project so as to secure letter of credit (LC).  at the onset of the Project with the remainder available as needed,
                                                                      dependant on contractual requirements
                                  Legal Costs are low for Owner. Owner negotiates only one   Legal Costs are higher for Owner. Owner negotiates multiple supply
                                  detailed supply contract with EPC contractor. EPC contractor  contracts directly with suppliers / contractor; with the assistance of
                                  must negotiate individual contracts with suppliers / vendors.  EPCM contractor.
                                  EPC contractor’s legal costs are high due to multiple   In the event of legal action is taken, Owner must bring legal action
             Legal Cost           contracts.                          against individual suppliers / contractors. (Usually a shorter process
                                  In the event of legal action is taken, Owner must sue EPC   than EPC legal actions)
                                  contractor, who in turn must bring legal action against
                                  appropriate suppliers / contractors. (Usually a longer
                                  process than EPCM legal actions)
                                  Owner’s administration costs are low with EPC contract.   Owner’s administration costs are higher with EPCM contracts.
                                  Only minimal staff (management, QC, legal, etc.) needed   Substantial staffing levels needed to assist/compliment EPCM
             Administration       to administer/monitor project. May have negative effect   contractor in administering/monitoring project.
                                  on project “ownership” feeling within Owner’s organization   Promotes “ownership” feeling within Owner’s organization. Project staff
                                  (Hands off).                        often transferred to operational staff after project completion.
