Page 37 - Industrial Plants
P. 37

the capital efficiency in large projects is not fully
            satisfactory.  Differences  are  wide  in  the  public  and
            private sector, in National Oil Companies (NOC) and
            joint stock companies, and among the field of activities
            [3].

            In oil and gas projects two major contracting
            approaches are used:
            1.  The single source LS contract basis, after a phase
                of project shaping (Design and Build or EPC
                LS(TK))
            2.  The multiple source Design-Bid-Build or EPCm/
                reimbursable style, in which engineering,
                procurement and construction are executed by
                different parties with only limited LS portions and
                interparties responsibility.

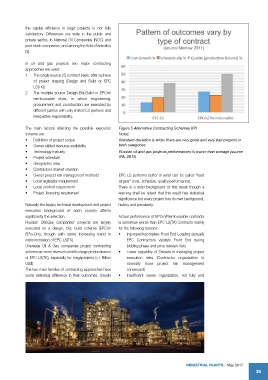

            The main factors affecting the possible execution   Figure 5 Alternative Contracting Schemes KPI
            scheme are:                               Notes:
            •   Definition of project scope           Standard deviation is wide: there are very good and very bad projects in
            •   Owner skilled resource availability   both categories
            •   Technology maturity                   Russian oil and gas projects performances is worse than average (source
            •   Project schedule                      IPA, 2012)
            •   Geographic area
            •   Contractors market situation
            •   Owner project risk management methods   EPC LS performs better in what can be called “hard
            •   Local legislation requirement         targets” (cost, schedule, quality/performance).
            •   Local content requirement             There is a solid background of this result though a
            •   Project financing requirement         warning shall be raised that this result has statistical
                                                      significance but every project has its own background,
            Naturally the legacy technical development and project   history and peculiarity.
            execution background of each country affects
            significantly the selection.              Actual performance of EPCm/Reimbursable contracts
            Russian Oil&Gas companies’ projects are largely   is somehow worse than EPC LS(TK) Contracts mainly
            executed on a design, bid, build scheme (EPCm/  for the following reasons:
            EPs+Cm), though with some increasing trend in   •   Improper/incomplete Front End Loading (actually
            implementation of EPC LS(TK).                EPC Contractors validate Front End during
            Overseas Oil & Gas companies project contracting   bidding phase and price relevant risk)
            scheme are more diverse but with a large predominance   •   Lower capability of Owners in managing project
            of EPC LS(TK), especially for megaprojects (>1 Billion   execution risks (Contractor organization is
            US$)                                         normally more project risk management
            The two main families of contracting approaches have   conversant)
            some statistical difference in their outcomes. Usually   •   Insufficient owner organization, not fully and
