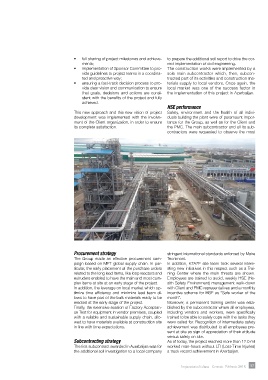

•   full sharing of project milestones and achieve-  to prepare the additional soil report to drive the cor-
                                     ments;                                rect implementation of civil engineering.
                                  •   implementation of Sponsor Committee to pro-  The construction works were implemented by a
                                     vide guidelines to project teams in a coordina-  sole main subcontractor which, then,  subcon-
                                     ted and proactive way;                tracted part of its activities and construction ma-
                                  •   ensuring a fast-track decision process to pro-  terials supply to local vendors. Once again, the
                                     vide clear vision and communication to ensure   local market was one of the success factor in
                                     that goals, decisions and actions are consi-  the implementation of this project in Azerbaijan.
                                     stent with the benefits of the project and fully
                                     achieved.
                                                                           HSE performance
                                  This new approach and this new vision of project   Safety, environment and the health of all indivi-
                                  development was implemented with the involve-  duals building the plant were of paramount impor-
                                  ment of the Client organization, in order to ensure   tance for the Group, as well as for the Client and
                                  its complete satisfaction.               the PMC. The main subcontractor and all its sub-
                                                                           contractors were requested to observe the most































                                  Procurement strategy                     stringent international standards enforced by Maire
                                  The Group made an effective procurement cam-  Tecnimont.
                                  paign based on MET global supply chain. In par-  In addition, KTAZE site team took several intere-
                                  ticular, the early placement of the purchase orders   sting new initiatives in this respect such as a Trai-
                                  related to the long lead items, like loop reactors and   ning Center where the main threats are shown.
                                  extruders enabled to have the main and most com-  Employees are trained to avoid, weekly HSE (He-
                                  plex items at site at an early stage of the project.  alth Safety Environment) management walk-down
                                  In addition, the leverage on local market which op-  with Client and PMC representatives and a monthly
                                  timize  time  efficiency  and  minimize  lead  team al-  incentive scheme for HSE as “Safe worker of the
                                  lows to have part of the bulk materials ready to be   month”.
                                  erected at the early stage of the project.  Moreover, a permanent training center was esta-
                                  Finally, the extensive session of Factory Acceptan-  blished by the subcontractor where all employees,
                                  ce Test for equipment in vendor premises, coupled   including vendors and workers, were specifically
                                  with a reliable and sustainable supply chain, allo-  trained to be able to safely cope with the tasks they
                                  wed to have materials available at construction site   were called for. Recognition of intermediate safety
                                  in line with time expectations.          achievement was distributed to all employees pre-
                                                                           sent at site as sign of appreciation of their attitude
                                                                           versus safety on site.
                                  Subcontracting strategy                  As of today, the project reached more than 12.0 mil
                                  The first subcontract awarded in Azerbaijan was for   worked man-hours without LTI (Lost-Time Injuries)
                                  the additional soil investigation to a local company   a track record achievement in Azerbaijan.



                                                                                 Impiantistica Italiana - Gennaio- Febbraio 2018  83
